02  Transport of World Biggest Goliath Gantry Cranes Under Preparation





 Goseong Port was a shallow  arrived at Sembcorp shipyard on   2nd shipment

 ❶ Item: Goliath 15000Ton Crane  water basin, so bridge barge  11th February 2019. SPMT was   Secondary transport for 2

 ❷  Q’TY : 1st shipment: 24Pkgs,   (10,000P) were used between  used for unloading. The problem   girder assemblies was the most
 7,404,000Kgs, 59,687.86Cbm
 the port and the dock. SPMT was  was that the edge of the pier   important highlight of this

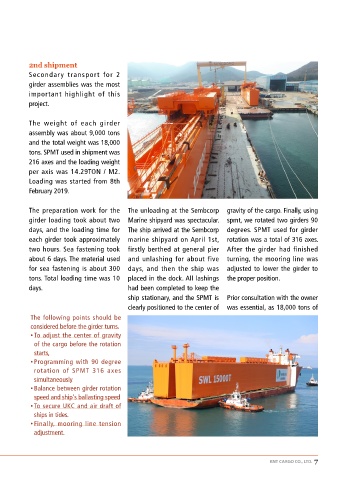

   2nd shipment: 2Pkgs,
 used for loading by Roll-on. Each  and the end of ship’s poop deck   project.
 16,812,000Kgs, 236,690.06Cbm
 bogie weighs approximately 250  were about 3M apart, and the
 ❸  Goseong, Korea / Sembcorp
 tons.  shipyard ground reinforce was   The weight of each girder
 Marine Shipyard, Singapore
 ❹  Equipment: DWT 50,000  The key to the first shipment was  mostly weak. So the width of the   assembly was about 9,000 tons
 self-propelled barge, Kramo 2   to balance the self-propelling  unloading area was quite limited   and the total weight was 18,000
 sets, SPMT 216 axles  barge with the bridge barge.  compared to the size of the cargo.   tons. SPMT used in shipment was
 ❺  Period: 24th January 2019 ~
 Bogie loading started two hours  In line with these conditions, we   216 axes and the loading weight
 08th April 2019
 before high tide to secure an air-  unloaded cargo by shifting the   per axis was 14.29TON / M2.
 draft. Loading and sea fastening  ship from side to side. Unloading   Loading was started from 8th
 embcorp Marine ordered  took about two weeks.  took about two weeks.  February 2019.
 Sa turnkey to Sangsang-in  The self-propelling barge was
 ship machinery that production,   The preparation work for the  The unloading at the Sembcorp  gravity of the cargo. Finally, using

 construction, engineering and   girder loading took about two  Marine shipyard was spectacular.  spmt, we rotated two girders 90
 transportation for 15,000-ton   days, and the loading time for  The ship arrived at the Sembcorp  degrees. SPMT used for girder
 Goliath crane 2 units.  each girder took approximately  marine shipyard on April 1st,  rotation was a total of 316 axes.
 The crane can lift up to 15,000   two hours. Sea fastening took  firstly berthed at general pier  After the girder had finished
 tons of ship blocks in one unit   about 6 days. The material used  and unlashing for about five  turning, the mooring line was
 and up to 30,000 tonnes of cargo   for sea fastening is about 300  days, and then the ship was  adjusted to lower the girder to
 when used both cranes.  tons. Total loading time was 10  placed in the dock. All lashings  the proper position.
 The assembled crane measures   days.         had been completed to keep the
 62m length, 185m width                       ship stationary, and the SPMT is  Prior consultation with the owner

 and 122m height. The cranes                  clearly positioned to the center of  was essential, as 18,000 tons of
 were separated by blocks and   The following points should be
 transported over a total of 2   considered before the girder turns.

 shipments on the DWT 50,000   •  To adjust the center of gravity
 class self-propelling barge.  of the cargo before the rotation
             starts,
 Knt Cargo was responsible   •   Programming with 90 degree
 for engineering the cranes   rotation of SPMT 316 axes

 for loading, unloading, ocean   simultaneously
 transport and seafastening.  •   Balance between girder rotation
             speed and ship's ballasting speed
 1st shipment  •   To secure UKC and air draft of
 The first transports were bogies,   ships in tides.
 legs and leg head blocks. It was   •   Finally, mooring line tension
 started from 24th January 2019   adjustment.
